Contents
1.4 Summary
of Construction Works
1.5 Summary
of EM&A Programme Requirements
2.3.2
Maintenance and Calibration
2.4 Summary
of Monitoring Results
3.3.2
Maintenance and Calibration
3.4 Summary
of Monitoring Results
5.3 Marine
Sediment Management
6 Chinese
White Dolphin Monitoring
6.2 CWD
Monitoring Methodology
6.2.1
Small Vessel Line-transect Survey
6.3 Monitoring
Results and Observations
6.3.1
Small Vessel Line-transect Survey
6.4 Site
Audit for CWD-related Mitigation Measures
6.5 Timing
of reporting CWD Monitoring Results
7 Environmental
Site Inspection and Audit
7.1 Environmental
Site Inspection
7.2 Landscape
and Visual Mitigation Measures
7.3 Land
Contamination Assessment
7.4 Audit
of SkyPier High Speed Ferries
7.5 Audit
of Construction and Associated Vessels
7.6 Implementation
of Dolphin Exclusion Zone
7.7 Status
of Submissions under Environmental Permits
7.8 Compliance
with Other Statutory Environmental Requirements
7.9 Analysis
and Interpretation of Complaints, Notification of Summons and Status of
Prosecutions
7.9.2
Notifications of Summons or Status of Prosecution
8 Future
Key Issues and Other EIA & EM&A Issues
8.1 Construction
Programme for the Coming Reporting Period
8.2 Key
Environmental Issues for the Coming Reporting Period
8.2.1
Construction Activities in the Coming Reporting Period
8.3 Monitoring
Schedule for the Coming Reporting Period
8.4 Review
of the Key Assumptions Adopted in the EIA Report
9 Conclusion
and Recommendation
Table
1.1: Contact Information of Key Personnel
Table
1.2: Summary of Status of All Environmental Aspects under the Updated EM&A
Manual
Table
2.1: Locations of Impact Air Quality Monitoring Stations
Table
2.2: Action and Limit Levels of Air Quality Monitoring
Table
2.3: Air Quality Monitoring Equipment
Table
2.4: Summary of Air Quality Monitoring Results
Table
3.1: Locations of Impact Noise Monitoring Stations
Table
3.2: Action and Limit Levels for Noise Monitoring
Table
3.3: Noise Monitoring Equipment
Table
3.4: Summary of Construction Noise Monitoring Results
Table
5.1: Action and Limit Levels for Construction Waste
Table
5.2: Construction Waste Statistics
Table
6.1: Coordinates of Transect Lines in NEL, NWL, AW, WL and SWL Survey Areas
Table
6.2: Summary of Photo Identification
Table
7.1: Landscape and Visual – Construction Phase Audit Summary
Table
7.2: Examples of Landscape and Visual Mitigation Measures in the Reporting
Period
Table
7.3: Monitoring Programme for Landscape and Visual
Table
7.4: Event and Action Plan for Landscape and Visual
Table
7.6: Summary of the Transplanted Trees Updated in the Reporting Period
Table
7.7: Status of Submissions under Environmental Permit
Locations of Air and Noise Monitoring Stations and Chek Lap Kok Wind Station |
|

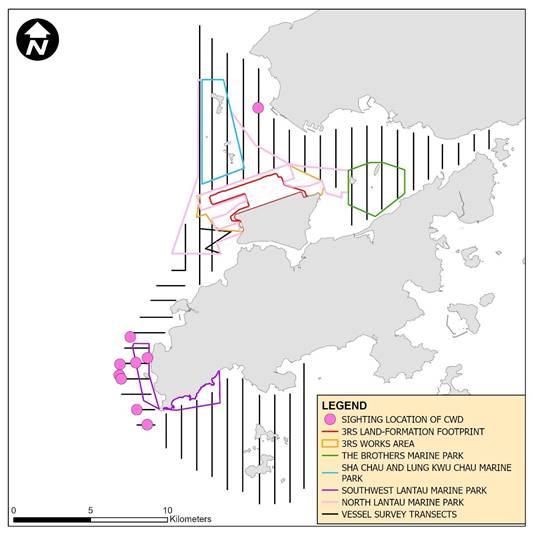

Vessel based Dolphin Monitoring Transects in Construction, Post-construction and Operation Phases |
|
Appendices
Environmental Mitigation Implementation Schedule (EMIS) for Construction Phase |
|
3RS |
Three-Runway System |
AAHK |
Airport Authority Hong Kong |
AECOM |
AECOM Asia Company Limited |
AFCD |
Agriculture, Fisheries and
Conservation Department |
AIS |
Automatic Information System |
ANI |
Encounter Rate of Number of
Dolphins |
APM |
Automated People Mover |
AW |
Airport West |
BHS |
Baggage Handling System |
C&D |
Construction and Demolition |
CAP |
Contamination Assessment Plan |
CAR |
Contamination Assessment Report |
CTCC |
Construction Traffic Control
Centre |
CWD |
Chinese White Dolphin |
DCM |
Deep Cement Mixing |
DEZ |
Dolphin Exclusion Zone |
DO |
Dissolved Oxygen |
EIA |
Environmental Impact Assessment |
EM&A |
Environmental Monitoring &
Audit |
EP |
Environmental Permit |
EPD |
Environmental Protection
Department |
EPSS |
Emergency Power Supply Systems |
ET |
Environmental Team |
FCZ |
Fish Culture Zone |
HDD |
Horizontal Directional Drilling |
HKBCF |
Hong Kong-Zhuhai-Macao Bridge
Hong Kong Boundary Crossing Facilities |
HKIA |
Hong Kong International Airport |
HOKLAS |
Hong Kong Laboratory
Accreditation Scheme |
HSF |
High Speed Ferry |
H2S |
Hydrogen Sulphide |
HVS |
High Volume Sampler |
I-2RS |
Interim Two-Runway System |
IEC |
Independent Environmental
Checker |
LKC |
Lung Kwu Chau |
MMHK |
Mott MacDonald Hong Kong Limited |
MMWP |
Marine Mammal Watching Plan |
MSS |
Maritime Surveillance System |
MTRMP-CAV |
Marine Travel Routes and
Management Plan for Construction and Associated Vessel |
NEL |
Northeast Lantau |
NLMP |
North Lantau Marine Park |
NWL |
Northwest Lantau |
PAM |
Passive Acoustic Monitoring |
PM |
Project Manager |
SC |
Sha Chau |
SCZ |
Speed Control Zone |
SCLKCMP |
Sha Chau and Lung Kwu Chau
Marine Park |
SS |
Suspended Solids |
SSSI |
Site of Special Scientific
Interest |
STG |
Encounter Rate of Number of
Dolphin Sightings |
SWL |
Southwest Lantau |
T2 |
Terminal 2 |
The Project |
The Expansion of Hong Kong International
Airport into a Three-Runway System |
The SkyPier Plan |
Marine Travel Routes and
Management Plan for High Speed Ferries of SkyPier |
The Manual |
The Updated EM&A Manual |
TSP |
Total Suspended Particulates |
WL |
West Lantau |
WMP |
Waste Management Plan |
The “Expansion of Hong Kong
International Airport into a Three-Runway System” (the Project) serves to meet
the future air traffic demands at Hong Kong International Airport (HKIA). On 7
November 2014, the Environmental Impact Assessment (EIA) Report (Register No.:
AEIAR-185/2014) for the Project was approved and an Environmental Permit (EP)
(Permit No.: EP-489/2014) was issued for the construction and operation of the
Project.
Airport Authority Hong Kong
(AAHK) commissioned Mott MacDonald Hong Kong Limited (MMHK) to undertake the
role of Environmental Team (ET) for carrying out the Environmental Monitoring
& Audit (EM&A) works during the construction phase of the Project in
accordance with the Updated EM&A Manual (the Manual).
This is the 113th
Construction Phase Monthly EM&A Report for the Project which summarises the
monitoring results and audit findings of the EM&A programme during the
reporting period from 1 to 31 May 2025.
The new North Runway was
commissioned in November 2022. Following the
completion of reconfiguration works on the Centre Runway, the Three-runway
System (3RS) was commissioned on 28 November 2024.
Key Activities in the
Reporting Period
The key activities of the Project carried out in the
reporting period are located in reclamation areas and existing airport island
respectively. Works in the reclamation areas included concourse superstructure
works, tunnel works for Automated People Mover (APM) and Baggage Handling
System (BHS) and associated works. Meanwhile, works on the existing airport
island involved Terminal 2 (T2) expansion works, modification and tunnel works
for APM and BHS, utilities works, road and drainage works and excavation works.
EM&A Activities
Conducted in the Reporting Period
The
monthly EM&A programme was undertaken in accordance with the Manual of the
Project. Summary of the monitoring activities during this reporting period is
presented as below:
Monitoring Activities |
Number of Sessions |
1-hour Total Suspended Particulates (TSP) air quality monitoring |
30 |
Noise monitoring |
18 |
Vessel line-transect surveys for operation phase Chinese White Dolphin (CWD) monitoring |
2 |
Environmental auditing works,
including weekly site inspections, ad-hoc site inspections of construction
works conducted by the ET and bi-weekly site inspections conducted by the
Independent Environmental Checker (IEC), audit of SkyPier High Speed Ferries
(HSF), audit of construction and associated vessels and audit of implementation
of Marine Mammal Watching Plan(MMWP) and Dolphin Exclusion Zone (DEZ) Plan were
conducted in the reporting period. Based
on the information including ET’s observations, records of Maritime
Surveillance System (MSS), and contractors’ site records, it is noted that
environmental pollution control and mitigation measures were properly
implemented and construction activities of the Project in the reporting period
did not introduce adverse impacts to the sensitive receivers.
Snapshots
of EM&A Activities in the Reporting Period
|
|
|
Dust Suppression Measure conducted by contractor |
Noise Impact Monitoring conducted by ET at Sha Lo Wan House |
Checking of Wastewater Treatment Facility by ET |
Results of Impact
Monitoring
The monitoring works for
construction dust, construction noise, construction waste and landscape & visual were conducted during the
reporting period in accordance with the Updated EM&A Manual.
Monitoring results of
construction dust, construction noise, and
construction waste did not trigger the corresponding Action and Limit Levels in
the reporting period. No non-conformity was recorded for landscape & visual
monitoring in the reporting period.
Summary of Upcoming Key
Issues
Reclamation
Works:
Contract
3206 Main Reclamation Works
·
Installation of precast units, scour apron,
armour rocks and miscellaneous works at eastern seawall.
Airfield
Works:
Contract
3305 Airfield Ground Lighting System
·
Cable laying works; and
·
Hardware installation works.
Contract 3310 North Runway Modification Works
·
Demolition of bulkhead wall, pavement,
drainage works, profile barrier, mechanical, electrical and plumbing works, and
architectural, builder's work and finishing works at vehicular tunnels;
·
Falsework and formwork;
·
Reinforced concrete works;
·
Drainage and watermain works; and
·
Architectural, builder's work and finishing
works at ancillary buildings.
Terminal 2 Concourse and Apron Works:
Contract
3404 Integrated Airport Control System
· System testing works.
Contract 3408 Third Runway Concourse and Apron Works
·
Building services and architectural, builder's
work and finishing works;
·
Cable laying and utilities works;
·
Pavement works;
·
Operation of concrete batching plant; and
·
Reinforced concrete works.
Terminal 2 Expansion:
Contract
3508 Terminal 2 Expansion Works
·
Architectural, builder's work and finishing
works;
·
Electrical and mechanical works;
·
Roof works;
·
Hard landscape works;
·
Link bridge works;
·
Emergency vehicular access construction;
·
Pier, deck, parapet and abutment construction;
·
Road works, drainage and utilities works; and
·
Crossroad duct laying works.
Automated People Mover and Baggage Handling System:
Contract
3601 New Automated People Mover System (TRC Line)
·
Guide beam installation; and
·
Cable containment and cable laying works.
Contract
3602 Existing APM System Modification Works
·
Restoration of buffer stop;
·
Platform screen door installation works; and
·
Steel fixing and formwork to track plinth.
Contract 3603
Baggage Handling System (BHS)
·
IT cabling and commissioning;
·
Steel work, mechanical, electrical, CCTV and
IT installation; and
·
Conveyor, electrical and fire service
installation.
Airport Support Infrastructure:
Contract
3801 APM and BHS Tunnels on Existing Airport Island
·
Slope levelling works; and
·
Construction of U-channel
Contract
3802 APM and BHS Tunnels and Related Works
·
Lateral supports and backfilling works;
·
Box culvert construction and superstructure
works;
·
APM and BHS Tunnel construction;
·
Reinforced concrete works; and
· Architectural, builder's work and finishing works.
Contract 3804 East and Landside
Fire Stations
·
Superstructure works;
·
Electrical and mechanical works;
·
Utilities works; and
·
Architectural, builder's work and finishing
works.
Contract
3805 New Airport District Police Operational Base
·
Construction of superstructures and drainage
system;
·
Installation of fuel tank; and
·
Site formation works.
Construction Support:
Contract
3901A Concrete Batching Facility
·
Operation of concrete batching plant and
material conveyor belt.
Contract
3901B Concrete Batching Facility
·
Decommissioning of concrete batching plant.
Contract
3908 Quay Management Services
·
Provision of services of site management and
logistic control of 3RS quays; and
·
Provision of flat top barge and vehicle
delivery services between the launching point in Hong Kong and 3RS quays.
Contract
3913 Asphalt Batching Plant
·
Operation of asphalt batching plant.
Summary Table
The following table summarises the key findings of the EM&A programme during the reporting period:
|
Yes |
No |
Details |
Analysis / Recommendation / Remedial Actions |
Breach of Limit Level^ |
|
√ |
No breach of Limit Level was recorded. |
Nil |
Breach of Action Level^ |
|
√ |
No breach of Action Level was recorded. |
Nil |
Complaint Received |
|
√ |
In the previous reporting period, a complaint regarding dust nuisance was received on 25 April 2025. |
ET investigated the case and found that mixing works had been carried out at South Wing Level 6 of Terminal 2 Concourse. The contractor enhanced dust mitigation measures and provided worker training. No dust-related issues were observed during ET’s inspections. The case is considered closed. |
Notification of any summons and status of prosecutions |
|
√ |
No notification of summons nor prosecution was received. |
Nil |
Change that affect the EM&A |
|
√ |
There was no change to the construction works that may affect the EM&A. |
Nil |
^ Only triggering of Action or Limit Level found related to Project works is counted as Breach of Action or Limit Level.
On 7 November 2014, the Environmental
Impact Assessment (EIA) Report (Register No.: AEIAR-185/2014) for the
“Expansion of Hong Kong International Airport into a Three-Runway System” (the
Project) was approved and an Environmental Permit (EP) (Permit No.:
EP-489/2014) was issued for the construction and operation of the Project.
Airport Authority Hong Kong
(AAHK) commissioned Mott MacDonald Hong Kong Limited (MMHK) to undertake the
role of Environmental Team (ET) for carrying out the Environmental Monitoring
& Audit (EM&A) works during the construction phase of the Project in
accordance with the Updated EM&A Manual (the Manual) submitted under EP
Condition 3.1[1].
AECOM Asia Company Limited (AECOM) was employed by AAHK as the Independent
Environmental Checker (IEC) for the Project.
The Project covers the expansion
of the existing airport into a three-runway system (3RS) with key project
components comprising land formation of about 650 ha and all associated
facilities and infrastructure including taxiways, aprons, aircraft stands, a
passenger concourse, an expanded Terminal 2 (T2), all related airside and
landside works and associated ancillary and supporting facilities. The
submarine aviation fuel pipelines and submarine power cables also require
diversion as part of the works.
Construction of the Project is to
proceed in the general order of diversion of the submarine aviation fuel
pipelines, diversion of the submarine power cables, land formation, and
construction of infrastructure, followed by construction of superstructures.
The new North Runway was
commissioned in November 2022. Since then, HKIA has continued to operate with
two runways, with the Centre Runway temporarily closed for reconfiguration. The
reconfiguration works included relevelling of the runway pavement to tie in
with connecting taxiways, constructing new runway entry and exit taxiways,
building new wrap-around taxiways at both ends of the runway. With the
completion of the reconfiguration works, the flight check and aircraft crash
and rescue exercise were completed on the Centre Runway in September and
October 2024 respectively. Thereafter, the Three-runway System (3RS) was
commissioned on 28 November 2024.
The
summary of construction works programme can be referred to Section 1.4.
This is the 113th
Construction Phase Monthly EM&A Report for the Project which summarises the
key findings of the EM&A programme during the reporting period from 1 to 31
May 2025.
The
Project’s organisation structure presented in Appendix B of the Construction
Phase Monthly EM&A Report No.1 remained unchanged during the reporting
period. Contact details of the key personnel are presented in Table 1.1.
Table 1.1: Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Project Manager’s
Representative (Airport Authority Hong
Kong) |
Principal Manager,
Environmental Compliance, Sustainability |
Lawrence Tsui |
2183 2734 |
Environmental Team (ET) (Mott MacDonald Hong
Kong Limited) |
Environmental Team
Leader |
Terence Kong |
2828 5919 |
Deputy Environmental
Team Leaders |
Heidi Yu |
2828 5704 |
|
Ken Wong |
2828 5817 |
||
Independent
Environmental Checker (IEC) (AECOM Asia Company
Limited) |
Independent
Environmental Checker |
Roy Man |
3729 0380 |
Deputy Independent
Environmental Checker |
Jackel Law |
3856 5312 |
Reclamation Works:
Party |
Position |
Name |
Telephone |
Contract
3206 Main
Reclamation Works (ZHEC-CCCC-CDC
Joint Venture) |
Project
Manager |
Alan
Mong |
3763
1352 |
Environmental
Officer |
Zhang
Bin Wang |
3763
1525 |
Airfield Works:
Party |
Position |
Name |
Telephone |
Contract 3305 Airfield Ground Lighting System (ADB Safegate Hong Kong Limited) |
Project Manager |
Allam Al-Turk |
2944 9725 |
Environmental Officer |
Ivan Ting |
9222 9490 |
|
Contract 3306 Observation Facility Control System Supporting Interim 2RS and 3RS (Chinney Alliance Engineering Limited) |
Project Director |
Dennis Yam |
9551 9920 |
Environmental Officer |
Richard Liu |
9216 8990 |
|
Contract 3308 Foreign Object Debris Detection System (DAS Aviation Services Group) |
Project Manager |
Jeffrey Yau |
9873 7422 |
Contract 3310 North Runway Modification Works (China State Construction Engineering (Hong Kong) Ltd.) |
Project Manager |
Kingsley Chiang |
9424 8437 |
Environmental Officer |
Federick Wong |
9842 2703 |
Terminal 2
Concourse and Apron Works:
Party |
Position |
Name |
Telephone |
Contract 3402 New Integrated Airport Centres Enabling Works (Wing Hing Construction Co., Ltd.) |
Project Manager |
Wyman Lau |
6112 9753 |
Health Safety Environmental Manager |
Mike Leung |
6625 2550 |
|
Contract 3404 Integrated Airport Control System (Shun Hing Systems Integration Co., Ltd.) |
Project Manager |
Andy Ng |
9102 2739 |
Environmental Officer |
Michael Lo |
6228 3926 |
|
Contract 3405 Third Runway Concourse Foundation and Substructure
Works (China Road and Bridge Corporation – Bachy Soletanche
Group Limited – LT Sambo Co., Ltd. Joint Venture) |
Project Manager |
Francis Choi |
9423 3469 |
Environmental Officer |
Jacky Lai |
9028 8975 |
|
Contract 3408 Third Runway Concourse and Apron Works (Beijing Urban Construction Group Company Limited and
Chevalier (Construction) Company Limited Joint Venture) |
Senior HSE Manager |
Qian Zhang |
5377 7976 |
Environmental Officer |
Ivan Mak |
9422 4805 |
Terminal
2 Expansion:
Party |
Position |
Name |
Telephone |
Contract 3508 Terminal 2 Expansion Works (Gammon Engineering &
Construction Company Limited) |
Project Director |
Richard Ellis |
6201 5637 |
Environmental Officer |
Carrie Kwan |
9276 0551 |
Automated People
Mover and Baggage Handling System:
Party |
Position |
Name |
Telephone |
Contract 3601 New Automated People Mover
System (TRC Line) (CRRC Puzhen Bombardier Transportation
Systems Limited and CRRC Nanjing Puzhen Co., Ltd. Joint Venture) |
Project Manager |
Hongdan Wei |
158 6180 9450 |
Environmental Officer |
H Y Yue |
9185 8186 |
|
Contract 3602 Existing APM System
Modification Works (Niigata Transys Co.,
Ltd.) |
Project Manager |
Xia Bo |
6586 4950 |
Environmental Officer |
Y M Tong |
5316 9801 |
|
Contract 3603 3RS Baggage Handling
System (VISH Consortium) |
Project Manager |
K C Ho |
9272 9626 |
Environmental Officer |
Richard Ng |
9802 9577 |
Airport
Support Infrastructure:
Party |
Position |
Name |
Telephone |
Contract 3801 APM and BHS Tunnels on
Existing Airport Island (China State Construction
Engineering (Hong Kong) Ltd.) |
Project Manager |
Kingsley Chiang |
9424 8437 |
Environmental Officer |
Eunice Kwok |
9243 1331 |
|
Contract 3802 APM and BHS Tunnels and
Related Works (Gammon Engineering &
Construction Company Limited) |
Project Director |
John Adams |
6111 6989 |
Environmental Officer |
Yan Ng |
5345 8555 |
|
Contract 3804 East and Landside Fire
Stations (Beijing Urban
Construction Group Company Limited -Beijing Urban Construction International
Company Limited - Kin Shing (Leung's)General Contractors Ltd Joint Venture) |
Project Manager |
Zhang Jinyuan |
6708 0506 |
Environmental
Representative |
Karis Lam |
6084 9745 |
|
Contract 3805 New Airport District
Police Operational Base (Chinney Construction Co.,
Ltd.) |
Project Manager |
Peter Li |
9628 0768 |
Environmental Officer |
Mike Li |
6306 8547 |
Construction Support:
Party |
Position |
Name |
Telephone |
Contract 3721 Construction Support
Infrastructure Works (China
State Construction Engineering (Hong Kong) Ltd.) |
Senior
Project Manager |
Thomas
Lui |
9011
5340 |
Environmental
Officer |
John
Mak |
6273
8703 |
|
Contract 3728 Minor Site Works (Shun
Yuen Construction Company Limited) |
Contract
Manager |
C K
Liu |
9194
8739 |
Environmental
Officer |
Dan
Leung |
6856
5899 |
|
Contract 3733 Emergency Repair Service (Wing
Hing Construction Co., Ltd.) |
Project
Manager |
Michael
Kan |
9206
0550 |
Safety
Health Environmental Manager |
Mike
Leung |
6625
2550 |
|
Contract 3901A Concrete Batching Facility (K.
Wah Concrete Company Limited) |
Project
Manager |
Benedict
Wong |
9553
2806 |
Environmental
Officer |
C P
Fung |
9874
2872 |
|
Contract 3901B Concrete Batching Facility (Gammon
Construction Limited) |
General
Manager |
Gabriel
Chan |
2435
3260 |
Environmental
Officer |
Rex
Wong |
2695
6319 |
|
Contract 3908 Quay Management Services (Gitanes
– Crown Asia Joint Venture) |
Project
Manager |
Mr.
Ian Li |
9750
6438 |
Environmental
Officer |
Mr.
Tang Kai Fun |
9406
3526 |
|
Contract 3913 Asphalt Batching Plant (SPR
Joint Venture) |
Project
Manager |
Xie
Yi Sheng |
6580
6005 |
Environmental
Officer |
Kenneth
Chan |
9300
2182 |
Utilities:
Party |
Position |
Name |
Telephone |
132 kV Cable (CLP
Power Hong Kong Limited
/ Kum Shing (K.F.) Construction
Company Limited) |
Engineer |
Ken Fung |
6391 9087 |
Project Engineer |
Kevin Wu |
6508 9779 |
The key
activities of the Project carried out in the reporting period are located in
reclamation areas and existing airport island, respectively. Works in the
reclamation areas included concourse superstructure works, tunnel works for APM
and BHS and associated works. Meanwhile, works on existing airport island
involved T2 expansion works, modification and tunnel works for APM and BHS,
utilities works, road and drainage works and excavation works.
The
locations of key construction activities are presented in Figure 1.1.
The
status for all environmental aspects is presented in Table
1.2. The EM&A requirements remained unchanged during the reporting
period.
Table 1.2: Summary of Status of All Environmental Aspects under the Updated EM&A Manual
Parameters |
EM&A Requirements |
Status |
Air Quality |
||
Baseline
Monitoring |
At
least 14 consecutive days before commencement of construction work |
The
baseline air quality monitoring result was reported in Baseline Monitoring
Report and submitted to EPD under EP Condition 3.4. |
Impact
Monitoring |
At
least 3 times every 6 days |
On-going |
Noise |
||
Baseline
Monitoring |
Daily
for a period of at least two weeks prior to the commencement of construction
works |
The
baseline noise monitoring result was reported in Baseline Monitoring Report
and submitted to EPD under EP Condition 3.4. |
Impact
Monitoring |
Weekly |
On-going |
Water Quality |
||
General
Baseline Water Quality Monitoring for reclamation, water jetting and field
joint works |
Three
days per week, at mid-flood and mid-ebb tides, for at least four weeks prior
to the commencement of marine works. |
The
baseline water quality monitoring result was reported in Baseline Water
Quality Monitoring Report and submitted to EPD under EP Condition 3.4. |
General
Baseline Water Quality Monitoring for reclamation, water jetting and field
joint works |
Three
days per week, at mid-flood and mid-ebb tides. |
General impact water quality monitoring for water
jetting works was completed on 23 May 2017. The
impact water quality monitoring was terminated after 31 October 2023. |
Initial
Intensive Deep Cement Mixing (DCM) Water Quality Monitoring |
At
least four weeks |
The
Initial Intensive DCM Monitoring Report was submitted and approved by EPD in
accordance with the Detailed Plan on DCM. |
Regular
DCM Water Quality Monitoring |
Three
times per week until completion of DCM works. |
Due
to the completion of all marine-based DCM works within April 2022, regular
DCM monitoring was ceased at all monitoring stations starting from 28 April
2022. |
Post-construction
phase water quality monitoring |
Three
days per week, at mid-flood and mid-ebb tides for four weeks |
The
four-week post-construction phase water quality monitoring exercise was
commenced on 14 November 2023 and completed on 9 December 2023. |
Sewerage and Sewage Treatment |
||
Methodology
for carrying out annual sewage flow monitoring for concerned gravity sewer |
Methodology
to be prepared and submitted to EPD one year before the scheduled
commencement of operation of the proposed third runway |
The
proposed methodology of the annual sewage flow monitoring was approved by
EPD. The annual flow monitoring was started from June 2021 and completed in
2022. |
Details
of the routine Hydrogen Sulphide (H2S) monitoring system for the sewerage
system of 3RS |
Details
to be prepared and submitted to EPD at least one year before commencement of
the operation of 3RS |
The
H2S monitoring was started after the commissioning of the 3RS on 28 November
2024. |
Waste Management |
||
Waste
Monitoring |
At
least weekly |
On-going
|
Land Contamination |
||
Supplementary
Contamination Assessment Plan (CAP) |
At
least 3 months before commencement of any soil remediation works. |
The
Supplementary CAP was submitted and approved by EPD under EP Condition 2.20. |
Site
Re-appraisal Summary Report for Fire Training Facility |
Site
Re-appraisal Summary Report for Fire Training Facility |
Site
Re-appraisal Summary Report for Fire Training Facility was submitted and
accepted by EPD. |
Contamination
Assessment Report (CAR) for Golf Course |
CAR
to be submitted for golf course |
The
CAR for Golf Course was submitted and accepted by EPD. |
Contamination
Assessment Reports (CAR) for Terminal 2 Emergency Power Supply Systems |
CAR
to be submitted for Terminal 2 Emergency Power Supply Systems |
The
CARs for Terminal 2 Emergency Power Supply Systems were submitted and
accepted by EPD. |
Terrestrial Ecology |
||
Pre-construction
Egretry Survey Plan |
Once
per month in the breeding season between April and July, prior to the
commencement of Horizontal Directional Drilling (HDD) drilling works. |
The
Egretry Survey Plan was submitted and approved by EPD under EP Condition
2.14. |
Ecological
Monitoring |
Monthly
monitoring during the HDD construction works period from August to March. |
The
terrestrial ecological monitoring at Sheung Sha Chau was completed in January
2019. |
Marine Ecology |
||
Pre-Construction
Phase Coral Dive Survey |
Prior
to marine construction works |
The
Coral Translocation Plan was submitted and approved by EPD under EP Condition
2.12. |
Coral
Translocation |
- |
The
coral translocation was completed. |
Post-Translocation
Coral Monitoring |
As
per an enhanced monitoring programme based on the Coral Translocation Plan |
The
post-translocation monitoring programme according to the Coral Translocation
Plan was completed in April 2018. |
Chinese White Dolphins (CWD) |
||
Baseline
Monitoring |
6 months of baseline surveys before the commencement of
land formation related construction works. Vessel line transect surveys: Two full surveys per
month; Land-based theodolite tracking surveys: Two days per
month at the Sha Chau station and two days per month at the Lung Kwu Chau
station; and Passive
Acoustic Monitoring (PAM): For the whole duration of baseline period. |
Baseline
CWD results were reported in the CWD Baseline Monitoring Report and submitted
to EPD in accordance with EP Condition 3.4. |
Impact
Monitoring |
Vessel line transect surveys: Two full surveys per
month; Land-based theodolite tracking surveys: One day per
month at the Sha Chau station and one day per month at the Lung Kwu Chau
station; and PAM:
For the whole duration for land formation related construction works. |
The
construction phase CWD monitoring was completed in December 2023. |
Post-construction
Phase Monitoring |
12 months of post-construction phase CWD monitoring
upon the completion of marine construction works. Vessel
line transect surveys: Two full surveys per month. |
The
post-construction phase CWD monitoring was completed in December 2024. |
Operation
Phase Monitoring |
12 months of operation phase CWD monitoring upon full
implementation of North Lantau Marine Park. Vessel
line transect surveys: Two full surveys per month. |
The
operation phase CWD monitoring was commenced in January 2025. |
Operation
Phase Audit |
SkyPier High Speed Ferries (HSF) implementation
measures: Once every three months for a period of one year upon operation of
3RS. Spill
Response Plan implementation measures: Once every six months for a period of
one year upon operation of 3RS. |
The 2nd audit was conducted in May 2025. The
1st audit was conducted in May 2025. |
Landscape &
Visual
|
||
Landscape
& Visual Plan |
At
least 3 months before the commencement of construction works on the formed
land of the Project. |
The
Landscape & Visual Plan was submitted and approved by EPD under EP
Condition 2.18. |
Baseline
Monitoring |
One-off
survey within the Project site boundary prior to commencement of any
construction works |
The
baseline landscape & visual monitoring result was reported in Baseline
Monitoring Report and submitted to EPD under EP Condition 3.4. |
Impact
Monitoring |
Weekly |
On-going |
Establishment
Works Monitoring |
Bi-monthly
|
On-going |
Long
Term Management (10 years) Monitoring |
Annually |
On-going |
Environmental Auditing |
||
Regular
site inspection |
Weekly |
On-going |
Marine
Mammal Watching Plan (MMWP) implementation measures |
Monitor
and check |
On-going |
Dolphin
Exclusion Zone (DEZ) Plan implementation measures |
Monitor
and check |
On-going |
SkyPier
High Speed Ferries (HSF) implementation measures |
Monitor
and check |
On-going |
Construction
and Associated Vessels Implementation measures |
Monitor
and check |
On-going |
Silt
Curtain Deployment Plan implementation measures |
Monitor
and check |
No
Silt Curtain Deployment Plan measures was implemented at C7a after 17 March
2025. |
Spill
Response Plan implementation measures |
Monitor
and check |
On-going
|
Complaint
Hotline and Email channel |
Construction
phase |
On-going |
Environmental
Log Book |
Construction
phase |
On-going |
Taking into account the
construction works in this reporting period, impact monitoring of air quality,
noise, waste management and landscape & visual were carried out in the
reporting period.
The EM&A programme also
involved weekly site inspections and related auditing conducted by the ET for
checking the implementation of the required environmental mitigation measures
recommended in the approved EIA Report. To promote
the environmental awareness and enhance the environmental performance of the
contractors, regular environmental management meetings were conducted
during the reporting period, which are summarised as below:
● Twelve environmental management
meetings for EM&A review with works contracts: 6, 13, 14, 15, 16, 22, 23
& 29 May 2025.
The EM&A programme has been following the recommendations presented in the approved EIA Report and the Manual. A summary of implementation status of the environmental mitigation measures for the construction phase of the Project during the reporting period is provided in Appendix A.
Air quality monitoring of 1-hour Total
Suspended Particulates (TSP) was conducted three times every six days at two
representative monitoring stations in the vicinity of air sensitive receivers
in Tung Chung and villages in North Lantau in accordance with the Manual. Table 2.1 describes the details of the monitoring
stations. Figure 2.1 shows
the locations of the monitoring stations.
Table 2.1: Locations of Impact Air Quality Monitoring Stations
Monitoring Station |
Location |
AR1A |
Man
Tung Road Park |
AR2 |
Village
House at Tin Sum |
In accordance with the Manual, baseline
air quality monitoring of 1-hour TSP levels at the two air quality monitoring
stations were established as presented in the Baseline Monitoring Report. The
Action and Limit Levels of the air quality monitoring stipulated in the
EM&A programme for triggering the relevant investigation and follow-up
procedures under the programme are provided in Table 2.2.
Table 2.2: Action and Limit Levels of Air Quality Monitoring
Monitoring Station |
Action Level (mg/m3) |
Limit Level (mg/m3) |
AR1A |
306 |
500 |
AR2 |
298 |
Portable direct reading dust meter
was used to carry out the air quality monitoring. Details of equipment used in
the reporting period are given in Table 2.3.
Table 2.3: Air Quality Monitoring Equipment
Equipment |
Brand and
Model
|
Last Calibration
Date
|
Calibration Certificate Provided in |
Portable direct
reading dust meter (Laser dust monitor) |
SIBATA LD-3B-1 (Serial
No. 597337) |
28 April 2025 |
The measurement procedures involved
in the impact air quality monitoring can be summarised as follows:
a. The portable direct reading dust meter was
mounted on a tripod at a height of 1.2m above the ground.
b. Prior to the measurement, the equipment was
set up for 1 minute span check and 6 second background check.
c. The one hour dust measurement was started.
Site conditions and dust sources at the nearby area were recorded on a record
sheet.
d. When the measurement completed, the “Count”
reading per hour was recorded for result calculation.
The portable direct reading dust
meter is calibrated every year against high volume sampler (HVS) to check the
validity and accuracy of the results measured by direct reading method. The
calibration record of the HVS provided in Appendix D of the Monthly EM&A
Report No. 103 and the calibration certificates of
portable direct reading dust meters listed in Table 2.3
are valid in the reporting period.
The air quality monitoring
schedule of the reporting period is provided
in Appendix B.
The air quality monitoring
results in the reporting period are summarised in Table
2.4. Detailed impact monitoring results are presented in Appendix C.
Table 2.4: Summary of Air Quality Monitoring Results
Monitoring Station |
1-hr TSP Concentration Range (mg/m3) |
Action Level (mg/m3) |
Limit Level (mg/m3) |
AR1A |
24 – 62 |
306 |
500 |
AR2 |
29 – 79 |
298 |
The monitoring results were within
the corresponding Action and Limit Levels at all monitoring stations in the
reporting period.
General meteorological conditions
throughout the impact monitoring period were recorded. Wind data including wind
speed and wind direction for each monitoring day were collected from the Chek
Lap Kok Wind Station.
No dust emission source was observed at the monitoring stations during the monitoring sessions. As the sensitive receivers were far away from the construction activities, with the implementation of dust control measures, there was no adverse impact at the sensitive receivers attributable to the works of the Project.
Noise monitoring in the form of
30-minute measurements of Leq, L10, and L90 levels
was conducted once per week between 0700 and 1900 on normal weekdays at four
representative monitoring stations in the vicinity of noise sensitive receivers
in Tung Chung and villages in North Lantau in accordance with the Manual. Table 3.1 describes the details of the monitoring
stations. Figure 2.1 shows
the locations of the monitoring stations.
Table 3.1: Locations of Impact Noise Monitoring Stations
Monitoring Station |
Location |
Type of measurement |
NM1A |
Man Tung Road Park |
Free field |
NM2(1) |
Tung Chung West Development |
To be determined |
NM3A(2) |
Site Office |
Façade |
NM4 |
Ching Chung Hau Po Woon Primary
School |
Free field |
NM5 |
Village House in Tin Sum |
Free field |
NM6 |
House No. 1, Sha Lo Wan |
Free field |
Notes:
(1) As
described in Section 4.3.3 of the Manual, noise monitoring at NM2 will only
commence after occupation of the future Tung Chung West Development.
(2) According to Section 4.3.3 of the
Manual, the noise monitoring at NM3A was temporarily suspended starting from 1
September 2018 and would be resumed with the completion of the Tung Chung East
Development.
In accordance with the Manual,
baseline noise levels at the noise monitoring stations were established as
presented in the Baseline Monitoring Report. The Action and Limit Levels of the
noise monitoring stipulated in the EM&A programme for triggering the
relevant investigation and follow-up procedures under the programme are
provided in Table 3.2.
Table 3.2: Action and Limit Levels for Noise Monitoring
Monitoring Stations |
Time Period |
Action Level |
Limit Level, Leq(30mins) dB(A) |
NM1A, NM2, NM3A, NM4, NM5 and NM6 |
0700-1900 hours on normal weekdays |
When one valid documented
complaint is received from any one of the sensitive receivers |
75dB(A)(1) |
Note:
(1) The
Limit Level for NM4 is reduced to 70dB(A) for being an educational institution.
During school examination period, the Limit Level is further reduced to
65dB(A).
Noise monitoring was performed using
sound level meter at each designated monitoring station. The sound level
meters deployed comply with the International Electrotechnical Commission
Publications 651:1979 (Type 1) and 804:1985 (Type 1) specifications. Acoustic
calibrator was used to check the sound level meters by a known sound pressure
level for field measurement. Details of equipment used in the reporting
period are given in Table 3.3.
Table 3.3: Noise Monitoring Equipment
Equipment
|
Brand
and Model |
Last
Calibration Date |
Calibration
Certificate Provided in |
Integrated Sound Level Meter |
Rion NL-52 (Serial No. 00998505) |
17 Feb 2025 |
Appendix D of Monthly EM&A
Report No. 111 |
Integrated Sound Level Meter |
Rion NL-52 (Serial No. 01287679) |
14 Oct 2024 |
Appendix D of Monthly EM&A
Report No.108 |
Acoustic Calibrator |
Castle GA607 (Serial No. 040162) |
17 Feb 2025 |
Appendix D of Monthly EM&A
Report No. 111 |
Acoustic Calibrator |
Casella CEL-120
(Serial No. 2383737) |
30 Jun 2024 |
Appendix D of Monthly EM&A
Report No.103 |
The monitoring procedures involved in the noise monitoring
can be summarised as follows:
a. The sound level meter was set on a tripod at
least a height of 1.2m above the ground for free-field measurements at
monitoring stations NM1A, NM4, NM5 and NM6. A correction of +3dB(A) was applied
to the free field measurements.
b. Façade measurements were made at the
monitoring station NM3A.
c. Parameters such as frequency weighting, time
weighting and measurement time were set.
d. Prior to and after each noise measurement, the
meter was calibrated using the acoustic calibrator. If the difference in
the calibration level before and after measurement was more than 1dB(A), the
measurement would be considered invalid and repeat of noise measurement would
be required after re-calibration or repair of the equipment.
e. During the monitoring period, Leq,
L10 and L90 were recorded. In addition, site conditions
and noise sources were recorded on a record sheet.
f. Noise measurement results, when higher than
the baseline monitoring levels, were corrected with reference to the baseline
monitoring levels.
g. Observations were recorded when high intrusive
noise (e.g., dog barking, helicopter noise) was observed during the monitoring.
The maintenance and calibration procedures are summarised
below:
a. The microphone head of the sound level meter
was cleaned with soft cloth at regular intervals.
b. The meter and calibrator were sent to the
supplier or laboratory accredited under Hong Kong Laboratory Accreditation
Scheme (HOKLAS) to check and calibrate at yearly intervals.
Calibration
certificates of the sound level meters, and acoustic calibrators used in the
noise monitoring listed in Table 3.3 are valid
in the reporting period.
The noise monitoring
schedule of reporting period is provided in Appendix B.
The noise monitoring results in
the reporting period are summarised in Table 3.4.
Detailed impact monitoring results are presented in Appendix C.
Table 3.4: Summary of Construction Noise Monitoring Results
Monitoring Station |
Noise Level Range, dB(A) Leq (30mins) |
Limit Level, dB(A) Leq (30mins) |
NM1A(1) |
63 - 65 |
75 |
NM4(1) (3) |
60 - 66 |
70(2) |
NM5(1)) |
55 - 59 |
75 |
NM6(1) (3) |
63 - 68 |
75 |
Notes:
(1) +3dB(A)
Façade correction included;
(2) The
limit level will be reduced to 65dB(A) during school examination periods at NM4.
No school examination took place during this reporting period.
(3) Some
of the noise measurement results were higher than the baseline monitoring
levels. To reduce the influence of non-Project related noise on the monitoring
results, these measurement results were corrected with reference to the
baseline monitoring results.
No complaints were received from
any sensitive receiver as listed in Table 3.1
that triggered the Action Level. All monitoring results were within the
corresponding Limit Levels at all monitoring stations in the reporting period.
As the construction activities were far away from the monitoring stations, major sources of noise dominating the monitoring stations observed during the construction noise impact monitoring were traffic noise near NM1A, school activities near NM4 and aircraft noise near NM6 during this reporting period. It is considered that the monitoring work during the reporting period was effective and there was no adverse impact attributable to the Project activities.
All water impact monitoring work has been completed, with results
presented in the Annual EM&A Report for 2023 and to
be included in the Final EM&A Report.
Based on the analysis presented in Annual EM&A Report for 2023, the
post-construction phase water quality monitoring did not reveal significant
changes of the water quality when comparing with baseline water quality
monitoring, and it can be concluded that the marine works of the Project during
construction phase did not cause deterioration in or adverse impacts on the
marine water quality surrounding the Project site.
In accordance with the Manual,
the waste generated from construction activities was audited once per week to
determine if wastes are being managed in accordance with the Waste Management
Plan (WMP) prepared for the Project, contract-specific WMP, and any statutory
and contractual requirements. All aspects of waste management including waste
generation, storage, transportation and disposal were assessed during the
audits.
The Action and Limit Levels of
the construction waste are provided in Table 5.1.
Table 5.1: Action and Limit Levels for Construction Waste
Monitoring Stations |
Action Level |
Limit Level |
Construction Area |
When one valid documented complaint is received |
Non-compliance of the WMP, contract-specific WMPs, any statutory and contractual requirements |
Weekly monitoring on all works
contracts were carried out by the ET to check and monitor the implementation of
proper waste management practices during the construction phase.
Recommendations made included
provision and maintenance of proper chemical waste storage area, as well as
handling, segregation, and regular disposal of general refuse. The contractors
have taken actions to implement the recommended measures. Waste management
audits were carried out by ET according to the requirement of the Waste
Management Plan, Updated EM&A Manual and the implementation schedule of the
waste management mitigation measures in Appendix
A.
Based on updated contractors’
information, construction waste generated in the reporting period is summarised
in Table 5.2. The ET
and IEC have carried out site audits regularly and reviewed the trip ticket
system. Dedicated areas for sorting of materials are established on site.
Recyclable materials such as steel bar, metal strip, aluminium, paper and
plastic are sorted on-site and transported off-site for recycling during this
reporting period.
Table 5.2: Construction Waste Statistics
|
C&D Material Stockpiled for Reuse or Recycle(1) (m3) |
C&D Material Reused in the Project (m3) |
C&D Material Reused in other Projects (m3) |
C&D Material Transferred to Public Fill (m3) |
Chemical Waste (kg) |
Chemical Waste (l) |
General Refuse (tonne) |
Apr 2025(2) |
760 |
1,885 |
0 |
4,680 |
0 |
0 |
4,336 |
May 2025(3) |
692 |
841 |
34 |
3,676 |
0 |
600 |
3,295 |
Notes: (1) C&D refers to Construction and
Demolition. (2) Updated figures were provided by
contractors. (3) The data was based on the information provided by contractors up to the submission date of this Monthly EM&A Report and might be updated in the forthcoming Monthly EM&A Report. |
There were no complaints,
non-compliance of the WMP, contract-specific WMPs, statutory and contractual requirements
that triggered Action and Limit Levels in the reporting period.
Marine sediment is managed
according to the EIA Report, Updated EM&A Manual, Waste Management Plan and
the proposal of Further Development on Treatment Level / Details and the Reuse
Mode for Marine Sediment (hereinafter referred to as “Further Development
Proposal”) of the Project. The storage conditions of the treated marine
sediment, and final backfilling location records were inspected and checked by
ET and verified by IEC to ensure they were in compliance with the requirements
as stipulated in the Waste Management Plan and Further Development Proposal.
Backfilling
works for treated marine sediment was conducted during the reporting
period. The
details of the marine sediment sampling, treatment and backfilling can be
referred to Annual EM&A Report.
In accordance with Section 10.2.3.2 (4) of the Updated
EM&A Manual, the operation phase CWD monitoring will be conducted for a
period of at least 12 months after the full implementation of the North Lantau
Marine Park (NLMP) at a frequency of two full surveys per month. Following the
full implementation of the NLMP and the completion of post-construction phase
CWD monitoring in December 2024, the operation phase CWD monitoring was
commenced in January 2025.
Small vessel line-transect
surveys were conducted along the transects covering Northeast Lantau (NEL),
Northwest Lantau (NWL), Airport West (AW), West Lantau (WL) and Southwest
Lantau (SWL) areas as proposed in the Manual, which are consistent with the Agriculture,
Fisheries and Conservation Department (AFCD) long-term monitoring programme
(except the addition of AW). The AW transect has not been previously surveyed
in the AFCD programme due to the restrictions of HKIA Approach Area,
nevertheless, this transect was established during the EIA of the 3RS Project
and refined in the Manual with the aim to collect project specific baseline
information within the HKIA Approach Area to fill the data gap that was not
covered by the AFCD programme. This also provided a larger sample size for
estimating the density, abundance and patterns of movements in the broader
study area of the project.
The planned vessel survey
transect lines for operation phase CWD monitoring following the waypoints set
for construction phase monitoring as proposed in the Manual are depicted in Figure 6.1 with the waypoint
coordinates of all transect lines given in Table 6.1,
which are subject to on-site refinement based on the actual survey conditions
and constraints.
Table 6.1: Coordinates of Transect Lines in NEL, NWL, AW, WL and SWL Survey Areas
Waypoint |
Easting |
Northing |
Waypoint |
Easting |
Northing |
NEL |
|||||
1S |
813525 |
820900 |
6N |
818568 |
824433 |
1N |
813525 |
824657 |
7S |
819532 |
821420 |
2S |
814556 |
818449 |
7N |
819532 |
824209 |
2N |
814559 |
824768 |
8S |
820451 |
822125 |
3S |
815542 |
818807 |
8N |
820451 |
823671 |
3N |
815542 |
824882 |
9S |
821504 |
822371 |
4S |
816506 |
819480 |
9N |
821504 |
823761 |
4N |
816506 |
824859 |
10S |
822513 |
823268 |
5S |
817537 |
820220 |
10N |
822513 |
824321 |
5N |
817537 |
824613 |
11S |
823477 |
823402 |
6S |
818568 |
820735 |
11N |
823477 |
824613 |
NWL |
|||||
1S |
804671 |
814577 |
5S |
808504 |
821735 |
1N |
804671 |
831404 |
5N |
808504 |
828602 |
2Sb |
805475 |
815457 |
6S |
809490 |
822075 |
2Nb |
805476 |
818571 |
6N |
809490 |
825352 |
2Sa |
805476 |
820770 |
7S |
810499 |
822323 |
2Na |
805476 |
830562 |
7N |
810499 |
824613 |
3S |
806464 |
821033 |
8S |
811508 |
821839 |
3N |
806464 |
829598 |
8N |
811508 |
824254 |
4S |
807518 |
821395 |
9S |
812516 |
821356 |
4N |
807518 |
829230 |
9N |
812516 |
824254 |
AW |
|||||
1W |
804733 |
818205 |
2W |
805045 |
816912 |
1E |
806708 |
818017 |
2E |
805960 |
816633 |
WL |
|||||
1W |
800600 |
805450 |
7W |
800400 |
811450 |
1E |
801760 |
805450 |
7E |
802400 |
811450 |
2W |
800300 |
806450 |
8W |
800800 |
812450 |
2E |
801750 |
806450 |
8E |
802900 |
812450 |
3W |
799600 |
807450 |
9W |
801500 |
813550 |
3E |
801500 |
807450 |
9E |
803120 |
813550 |
4W |
799400 |
808450 |
10W |
801880 |
814500 |
4E |
801430 |
808450 |
10E |
803700 |
814500 |
5W |
799500 |
809450 |
11W |
802860 |
815500 |
5E |
801300 |
809450 |
12S/11E |
803750 |
815500 |
6W |
799800 |
810450 |
12N |
803750 |
818500 |
6E |
801400 |
810450 |
|
|
|
SWL |
|||||
1S |
802494 |
803961 |
6S |
807467 |
801137 |
1N |
802494 |
806174 |
6N |
807467 |
808458 |
2S |
803489 |
803280 |
7S |
808553 |
800329 |
2N |
803489 |
806720 |
7N |
808553 |
807377 |
3S |
804484 |
802509 |
8S |
809547 |
800338 |
3N |
804484 |
807048 |
8N |
809547 |
807396 |
4S |
805478 |
802105 |
9S |
810542 |
800423 |
4N |
805478 |
807556 |
9N |
810542 |
807462 |
5S |
806473 |
801250 |
10S |
811446 |
801335 |
5N |
806473 |
808458 |
10N |
811446 |
809436 |
Small vessel line-transect surveys
provided data for density and abundance estimation and other assessments using
distance-sampling methodologies, specifically, line-transect methods.
The surveys involved small vessel
line-transect data collection and have been designed to be similar to, and
consistent with, previous surveys for the AFCD for their long-term monitoring
of small cetaceans in Hong Kong. The survey was designed to provide systematic,
quantitative measurements of density, abundance and habitat use.
● Primary transect lines: the parallel
and zigzag transect lines as shown in Figure
6.1; and
● Secondary transect lines: transect
lines connecting between the primary transect lines and going around islands.
All data collected on both
primary and secondary transect lines were used for analysis of sighting
distribution, group size, activities including association with fishing boat,
and mother-calf pairs. Only on-effort data collected under favourable conditions
of Beaufort 0-3 and visibility of approximately 1200 m or beyond were used for
analysis of the CWD encounter rates.
A 15-20m vessel with a flying
bridge observation platform about 4 to 5m above water level and unobstructed
forward view, and a team of three to four observers were deployed to undertake
the surveys. Two observers were on search effort at all times when
following the transect lines with a constant speed of 7 to 8 knots (i.e. 13 to
15 km per hour), one using 7X handheld binoculars and the other using unaided
eyes and recording data.
During on-effort survey periods,
the survey team recorded effort data including time, position (waypoints),
weather conditions (Beaufort sea state and visibility) and distance travelled
in each series with assistance of a handheld GPS device. The GPS device also
continuously and automatically logged data including time, position (latitude
and longitude) and vessel speed throughout the entire survey.
When CWDs were seen, the survey
team was taken off-effort, the dolphins were approached and photographed for
photo-ID information (using a Canon 7D [or similar] camera and long 300 mm+
telephoto lens), then followed until they were lost from view. At that
point, the boat returned (off effort) to the survey line at the closest point
after obtaining photo records of the dolphin group and began to survey on
effort again.
Focal follows of dolphins would
be used for providing supplementary information only where practicable (i.e.
when individual dolphins or small stable groups of dolphins with at least one
member that could be readily identifiable with unaided eyes during observations
and weather conditions are favourable). These would involve the boat following
(at an appropriate distance to minimise disturbance) an identifiable individual
dolphin for an extended period of time, and collecting detailed data on its
location, behaviour, response to vessels, and associates.
CWDs can be identified by their
unique features like presence of scratches, nick marks, cuts, wounds,
deformities of their dorsal fin and distinguished colouration and spotting
patterns.
When CWDs were observed, the
survey team was taken off-effort, the dolphins were approached and photographed
for photo-ID information (using a Canon 7D [or similar] camera and long 300 mm+
telephoto lens). The survey team attempted to photograph both sides of every
single dolphin in the group as the colouration and spotting pattern on both
sides may not be identical. The photos were taken at the highest available
resolution and stored on Compact Flash memory cards for transferring into a
computer.
All photos taken were initially examined
to sort out those containing potentially identifiable individuals. These
sorted-out images would then be examined in detail and compared to the CWD
photo-identification catalogue established for 3RS Project since the baseline
monitoring stage.
Survey Effort
Within this reporting period, two
complete sets of small vessel line-transect surveys were conducted on the 6, 9,
15, 16, 19, 20, 21 and 23 May 2025 covering all transects in NEL, NWL, AW, WL
and SWL survey areas for twice.
A total of around 450.5 km of
survey effort was collected from these surveys and around 438.6 km of survey
effort was being conducted under favourable weather condition (i.e. Beaufort
Sea State 3 or below with favourable visibility). Details of the survey effort
are given in Appendix C.
Sighting
Distribution
In the current reporting period, nine sightings with 19
dolphins were sighted. All these sightings were on-effort records under
favourable weather condition (i.e. Beaufort Sea State 3 or below with
favourable visibility). Details of dolphin sightings are presented in Appendix C.
Distribution of all CWD sightings
recorded in the current reporting period is illustrated in Figure
6.2. In WL, the majority of CWD sightings were scattered between Yi O
and Fan Lau. In NWL, a CWD sighting was recorded at the waters near Castle Peak
Power Station. It’s been a while since last sighting in this part of the NWL
survey area dated back to 2022. There was no CWD sighting recorded in SWL and
NEL during the reporting period.
Figure 6.2:
Sightings Distribution of Chinese White Dolphins
Remarks: (1) Please note that there are nine pink circles on
the map indicating the sighting locations of CWDs. (2) Marine park excludes
land area and the landward boundary generally follows the high water mark along
the coastline.
Group
Size
In the current reporting period,
nine groups with 19 dolphins in total were sighted, and the average group size
of CWDs was 2.1 dolphins per group. Most of the CWD sightings were having small
group size (i.e. 1-2 dolphins) and no CWD sighting with large group size (i.e.
10 or more dolphins) was recorded during the current reporting period.
Activities
and Association with Fishing Boats
There were
two CWD sightings recorded engaging in foraging activities in WL during the
current reporting period. Both sightings were observed in association with
operating purse seiner in WL.
Mother-calf
Pair
In this reporting period, there
was a CWD sighting recorded with the presence of mother-and-unspotted juvenile
pair(s) in WL.
In the current reporting period,
a total number of nine different CWD individuals were identified for a total of
nine times. A summary of photo identification works is presented in Table 6.2. Representative photos of these individuals
are given in Appendix C.
Table 6.2: Summary of Photo Identification
Individual ID |
Date of Sighting (dd-mmm-yy) |
Sighting Group No. |
Area |
|
Individual ID |
Date of Sighting (dd-mmm-yy) |
Sighting Group No. |
Area |
NLMM013 |
9-May-25 |
1 |
NWL |
|
WLMM067 |
16-May-25 |
4 |
WL |
NLMM095 |
9-May-25 |
1 |
NWL |
|
WLMM068 |
16-May-25 |
4 |
WL |
SLMM034 |
16-May-25 |
3 |
WL |
|
WLMM111 |
16-May-25 |
4 |
WL |
SLMM050 |
16-May-25 |
4 |
WL |
|
WLMM162 |
16-May-25 |
4 |
WL |
WLMM043 |
16-May-25 |
3 |
WL |
|
|
During the reporting period, one
dolphin observation station and team of at least two dolphin observers was
deployed by the contractor for continuous monitoring of the DEZ for rock armour
laying works in accordance with the DEZ Plan. During this reporting period, no
training session were provided by the ET for the proposed dolphin observers.
From the contractor’s records, no dolphin or other marine mammals were observed
this reporting month. The contractor’s records were also audited by ET during
site inspection.
The construction vessel
management are presented in Section 7.5 below.
According to Section 10.6.2.2 of
the Updated EM&A Manual, audits of HSF implementation measures and Spill
Responses Plan implementation measures will be conducted once every three
months and every six months respectively for one year upon operation of 3RS.
The second audit of HSF implementation measures was conducted in May 2025.
During the audit period from 1 March 2025 to 31 May 2025, no SkyPier HSFs were
recorded travelling between HKIA SkyPier and Zhuhai/Macau. The first audit of
the Spill Responses Plan measures was conducted in May 2025.
Detailed analysis of CWD
monitoring results collected by small vessel line-transect survey will be
provided in upcoming quarterly reports and annual report.
Following the full implementation of the NLMP and the completion of post-construction phase CWD monitoring in December 2024, the operation phase CWD monitoring was commenced in January 2025.
Site
inspections of the construction works to audit the implementation of proper
environmental pollution control and mitigation measures for the Project were
conducted by ET and IEC on a weekly and bi-weekly basis, respectively. The
weekly site inspection schedule of the construction works is provided in Appendix B. Besides, ad-hoc site
inspections were also conducted by ET and IEC if environmental problems were
identified, or subsequent to receipt of an environmental complaint, or as part
of the investigation work. These site inspections provided a direct means to
reinforce the specified environmental protection requirements and pollution
control measures in construction sites.
During site inspections,
environmental situation, status of implementation of pollution control and
mitigation measures were observed. Environmental documents and site records,
including waste disposal record, maintenance record of environmental equipment,
and relevant environmental permit and licences, were also checked on site. Observations were recorded in the
site inspection checklist and passed to the contractor together with the
recommended mitigation measures where necessary in order to advise
contractors on environmental improvement, awareness and on-site enhancement
measures. The
observations were made with reference to the following information during the
site inspections:
·
The EIA and EM&A requirements;
·
Relevant environmental protection laws, guidelines, and practice notes;
·
The EP conditions and other submissions under the EP;
·
Monitoring results of EM&A programme;
·
Works progress and programme;
·
Proposal of individual works;
·
Contract specifications on environmental protection; and
·
Previous site inspection results.
Good site practices were observed
in site inspections during the reporting period. Advice was given when
necessary to ensure the construction workforce were familiar with relevant
procedures, and to maintain good environmental performance on site. Regular
toolbox talks on environmental issues were organised for the construction
workforce by the contractors to ensure understanding and proper implementation
of environmental protection and pollution control mitigation measures.
A summary of implementation
status of the environmental mitigation measures for the construction phase of
the Project during the reporting period is provided in Appendix A.
Implementation of applicable
landscape and visual mitigation measures (reference to the environmental
protection measures CM1 – CM10 and OM7 in Appendix A) was monitored in
accordance with the Manual. All measures undertaken by both the contractor and
the landscape contractor during the construction phase and first year of the
operation phase shall be audited by a landscape architect, as a member of the ET,
on a regular basis to ensure compliance with the intended aims of the measures.
Site inspections shall be undertaken at least once every two months during the
first year of the operation phase.
The
implementation status of the environmental protection measures is summarized
below in Table 7.1. Examples of landscape and
visual mitigation measures are shown in Table 7.2.
The monitoring programme for detailed design, construction, establishment works
and long term management (10 years) stages is presented in Table 7.3. Event and Action Plan for Landscape and
Visual impacts is stated in Table 7.4.
Table 7.1: Landscape and Visual – Construction Phase Audit Summary
Landscape and Visual
Mitigation Measures during Construction |
Implementation Status |
Relevant Contract(s)
in the Reporting Period |
CM1 – The construction area and
contractor’s temporary works areas shall be minimised to avoid impacts on
adjacent landscape. |
The implementation of mitigation
measures was checked by ET during weekly site inspection and reported by the
Contractors during the monthly Environmental Management Meetings.
Implementation of the measures CM5, CM6 and CM7 by Contractors was observed. |
All works contracts |
CM2 – Reduction of construction
period to practical minimum |
||
CM3 – Phasing of the construction
stage to reduce visual impacts during the construction phase. |
||
CM4 – Construction traffic (land and
sea) including construction plants, construction vessels and barges shall be
kept to a practical minimum. |
||
CM5 – Erection of decorative mesh
screens or construction hoardings around works areas in visually unobtrusive
colours. |
||
CM6 – Avoidance of excessive height
and bulk of site buildings and structures |
||
CM7 – Control of night-time lighting
by hooding all lights and through minimisation of night working periods |
||
CM8 – All existing trees shall be
carefully protected during construction. Detailed Tree Protection
Specification shall be provided in the Contract Specification. Under this
specification, the Contractor shall be required to submit, for approval, a
detailed working method statement for the protection of trees prior to
undertaking any works adjacent to all retained trees, including trees in
contractor’s works areas |
Tree Protection Specifications
were provided in the relevant Contract Specifications respectively for
implementation by the Contractors under the Project. The Contractors’ performance on the
implementation of the tree maintenance and protection measures were observed
and checked by the ET weekly during construction period. |
3508, 132kV Cable |
CM9 – Trees unavoidably affected by
the works shall be transplanted where practical. A detailed Tree
Transplanting Specification shall be provided in the Contract Specification,
if applicable. Sufficient time for necessary tree root and crown preparation
periods shall be allowed in the project programme |
Tree Transplanting Specifications
were provided in the relevant Contract Specifications respectively for
implementation by the Contractors under the Project where trees would
unavoidably be affected by the construction works. The Contractors were
required to submit Method Statements for tree transplanting prior to the
transplanting works. Tree inspections were conducted by ET to check the tree
transplanting works implemented by the Contractors on site. The Contractors’ performance
on the implementation of trees maintenance and protection measures on
transplanted trees were observed and checked by the ET bi-monthly during the
12-month establishment period after the completion of each batch of
transplanting works. Long term management of the
transplanted trees was currently monitored by ET annually. |
3508 |
CM10 – Land formation works shall be
followed with advanced hydroseeding around taxiways and runways as soon as
practical |
The implementation of advanced
hydroseeding works by the Contractors were completed. |
- |
OM7 – Compensatory tree planting for
all felled trees shall be provided to the satisfaction of relevant Government
departments. Required numbers and locations of compensatory trees shall
be determined and agreed separately with Government during the Tree Felling
Application process under the relevant technical circulars.(1) |
Compensatory trees have been
planted in batches at different time periods. The compensatory trees were
checked by ET bi-monthly during the 12-month establishment period after the
completion of each batch of compensatory tree planting works. Subsequently, the trees were
monitored annually throughout the 10-year long-term management period,
succeeding the establishment period for each batch of compensatory planting. |
AAHK |
(1) AAHK is the management and maintenance
agency of the compensatory trees. Tree Felling Application is not required for
3RS project.
Table 7.2: Examples of Landscape and Visual Mitigation Measures in the Reporting Period
|
|
|
Erection of
site hoardings around works area in unobtrusive colours (CM5) |
Avoidance of
excessive height and bulk of site buildings (CM6) |
Control of
night-time lighting using light hooding and minimisation of night working
period (CM7) |
|
|
|
General view
of retained tree (CM8) |
General view
of transplanted trees (CM9) |
General view
of compensatory tree planting (OM7) |
In accordance with the Updated
EM&A Manual, all existing trees shall be protected carefully during
construction. Trees unavoidably affected by the works shall be transplanted
where practical. In this reporting period, the cumulative total number of retained
trees and transplanted trees under the Project remained unchanged (i.e. 76 and
26 respectively) comparing to the previous reporting period. No non-conformity
was recorded in the reporting period.
Details of the retained trees,
transplanted trees and to-be-transplanted trees under the Project are
summarized in Table 7.5. Details of the retained
trees are to be discussed in the Quarterly EM&A reports.
Table 7.3: Monitoring Programme for Landscape and Visual
Stage |
Monitoring Task |
Monitoring Report |
Form of Approval |
Frequency |
Detailed Design |
Checking of design
works against the recommendations of the landscape and visual impact assessments
within the EIA shall be undertaken during detailed design and tender stage,
to ensure that they fulfil the intention of the mitigation measures. Any
changes to the design, including design changes on site shall also be
checked. |
Report by AAHK / PM
confirming that the design conforms to requirements of EP. |
Approved by Client |
At the end of the
Detailed Design Phase |
Construction |
Checking of the contractor’s
operations during the construction period. |
Report on Contractor's
compliance, by ET |
Counter signature of
report by IEC |
Weekly |
Establishment Works |
Checking of the
planting works during the twelve-month Establishment Period after completion
of each batch of transplanting works or compensatory tree planting works. |
Report on Contractor's
compliance, by ET |
Counter signature of
report by IEC |
Every two months |
Long Term Management
(10 year) |
Monitoring of the long-term
management of the planting works in the period up to 10 years after
completion of each batch of transplanting works or compensatory tree planting
works. |
Report on compliance
by ET or maintenance Agency as appropriate |
Counter signature of
report by Management Agency |
Annually |
Table 7.4: Event and Action Plan for Landscape and Visual
Event Action Level |
Action |
|||
ET |
IEC |
AAHK / PM |
Contractor |
|
Design Check |
Check final design conforms to the
requirements of EP and prepare report. |
Check report. Recommend remedial design if
necessary. |
Undertake remedial design if
necessary. |
|
Non-conformity on one occasion |
Identify source. Inform IEC and AAHK / PM. Discuss remedial actions with IEC, AAHK / PM and Contractor. Monitor remedial actions until
rectification has been completed. |
Check report. Check Contractor’s working method. Discuss with ET and Contractor on possible remedial measures. Advise AAHK / PM on effectiveness of proposed remedial measures. Check implementation of remedial
measures. |
Notify Contractor. Ensure remedial measures are
properly implemented. |
Amend working methods to prevent
recurrence of non-conformity. Rectify damage and undertake
additional action necessary. |
Repeated Non-conformity |
Identify source. Inform IEC and AAHK / PM. Increase monitoring frequency. Discuss remedial actions with IEC, AAHK / PM and Contractor. Monitor remedial actions until rectification has been completed. If non-conformity stops, cease
additional monitoring. |
Check monitoring report. Check Contractor’s working method. Discuss with ET and Contractor on possible remedial measures. Advise AAHK / PM on effectiveness of proposed remedial measures. Supervise implementation of
remedial measures. |
Notify Contractor. Ensure remedial measures area
properly implemented. |
Amend working methods to prevent
recurrence of non-conformity. Rectify damage and undertake
additional action necessary. |
Table 7.5: Summary of
the Number of Retained, Transplanted and To-be-transplanted Trees in the
Reporting Period
Contract No. / Works |
Retain (nos.) |
Transplanted (nos.) |
To-be-transplanted (nos.) |
|
Establishment Period |
Maintenance Period |
|||
3503 |
0 |
0 |
9(1) |
0 |
3508 |
24 |
0 |
12 |
0 |
3801 |
0 |
0 |
5(2) |
0 |
132kV Cable |
52 |
0 |
0 |
0 |
Grand Total |
76 |
0 |
26 |
0 |
Note:
(1) Contract 3503 was completed. The 9 transplanted trees, including
T835, T836, T838, T812, T814, T815, T829, T830 and T831 were handed over to
AAHK in February 2022.
(2) The 5 transplanted trees including CT276, CT1253, CT1194, CT1794 and
CT1795 have been handed over to other management agencies. Details of the
management agency are presented in Table 7.6.
Summary of the updated transplanted trees are presented in
Table 7.6.
Table 7.6: Summary of the Transplanted Trees Updated in the Reporting Period
Tree ID |
Transplant Date |
Management Stage |
Management Agency |
Remarks |
CT276 |
3 May 2018 |
Long Term Management period Jun 2019 – May 2028 |
Southern Landside
Petrol Filling Station |
Establishment Period was
completed. Next inspection will be conducted in February 2026. Photos of the
last inspection in February 2025 can be referred to Table 7.7 of the
Construction Phase Monthly EM&A Report No.110. |
CT1253 |
4 May 2018 |
Long Term Management period Jun 2019 – May 2028 |
Southern Landside
Petrol Filling Station |
|
T835 |
22 Jan 2020 |
Long Term Management period Feb 2021 – Jan 2030 |
AAHK |
Establishment Period
was completed. The tree within the land parcel was acquired for construction
of infrastructure. The tree was felled in 2023. |
T836 |
13 Dec 2019 |
Long Term Management period Feb 2021 – Jan 2030 |
AAHK |
|
T838 |
22 Jan 2020 |
Long Term Management period Feb 2021 – Jan 2030 |
AAHK |
|
T812 |
21 Dec 2020 |
Long Term Management period Jan 2022 – Dec 2031 |
AAHK |
Establishment Period
was completed. Next inspection will be conducted in December 2025. Photos
of the last inspection in December 2024 can be referred to Table 7.7 of the
Construction Phase Monthly EM&A Report No.108. |
T814 |
20 Dec 2020 |
Long Term Management period Jan 2022 – Dec 2031 |
AAHK |
|
T815 |
15 Dec 2020 |
Long Term Management period Jan 2022 – Dec 2031 |
AAHK |
|
T829 |
18 Dec 2020 |
Long Term Management period Jan 2022 – Dec 2031 |
AAHK |
|
T830 |
14 Dec 2020 |
Long Term Management period Jan 2022 – Dec 2031 |
AAHK |
|
T831 |
19 Dec 2020 |
Long Term Management period Jan 2022 – Dec 2031 |
AAHK |
|
T1493 |
6 Jul 2021 |
Long Term Management period Aug 2022 – Jul 2031 |
Contract 3508 |
Establishment Period
was completed. Next inspection will be conducted in July 2025. Photos of the
last inspection in July 2024 can be referred to Table 7.7 of the Construction
Phase Monthly EM&A Report No.103. |
T1494 |
6 Jul 2021 |
Long Term Management period Aug 2022 – Jul 2031 |
Contract 3508 |
|
T1495 |
10 Jul 2021 |
Long Term Management period Aug 2022 – Jul 2031 |
Contract 3508 |
|
T1496 |
5 Jul 2021 |
Long Term Management period Aug 2022 – Jul 2031 |
Contract 3508 |
|
T1497 |
5 Jul 2021 |
Long Term Management period Aug 2022 – Jul 2031 |
Contract 3508 |
|
T1498 |
29 Jun 2021 |
Long Term Management period Aug 2022 – Jul 2031 |
Contract 3508 |
|
T1499 |
29 Jun 2021 |
Long Term Management period Aug 2022 – Jul 2031 |
Contract 3508 |
|
T1500 |
30 Jun 2021 |
Long Term Management period Aug 2022 – Jul 2031 |
Contract 3508 |
|
T1501 |
30 Jun 2021 |
Long Term Management period Aug 2022 – Jul 2031 |
Contract 3508 |
|
T1502 |
5 Jul 2021 |
Long Term Management period Aug 2022 – Jul 2031 |
Contract 3508 |
|
T1503 |
6 Jul 2021 |
Long Term Management period Aug 2022 – Jul 2031 |
Contract 3508 |
|
T1504 |
24 Jun 2021 |
Long Term Management period Aug 2022 – Jul 2031 |
Contract 3508 |
|
CT1194 |
4 May 2018 |
Long Term Management period Jun 2019 – May 2028 |
Southern Landside
Petrol Filling Station |
Establishment Period
was completed. Uprooted and collapsed due to Typhoon Higos on 18 August 2020.
Tree removal was conducted as recommended by tree specialist of the
contractor of Southern Landside Petrol Filing Station. |
CT1794 |
3 May 2018 |
Long Term Management period Jun 2019 – May 2028 |
AsiaWorld-Expo |
Establishment Period was
completed. The tree within the land parcel was acquired by the government for
construction of emergency hospital to handle COVID19 pandemic at
AsiaWorld-Expo. The tree was felled in late 2020. |
CT1795 |
3 May 2018 |
Long Term Management period Jun 2019 – May 2028 |
AsiaWorld-Expo |
Establishment Period
was completed. The tree within the land parcel was acquired by the government
for construction of emergency hospital to handle COVID19 pandemic at
AsiaWorld-Expo. The tree was felled in late 2020. |
The Supplementary CAP was
submitted to EPD pursuant to EP Condition 2.20. The CARs for Golf Course and T2
Emergency Power Supply Systems (EPSS) were submitted to EPD in accordance with
EP Condition 1.9 and the Supplementary CAP in which no land contamination
issues were identified. EPD issued no further comment for aforesaid CARs. No
leakage was found after the removal of underground fuel pipelines of T2 EPSS
and all required additional photos have been submitted to EPD.
According to the approved
supplementary CAP, there are 3 remaining locations where site re-appraisal /
additional site investigation are proposed. The site re-appraisal summary
report for Fire Training Facility was submitted and accepted by EPD on 20 December
2023. The status of site re-appraisal/ additional site investigation of the 2
remaining locations (Fuel Tank Room to the west of CAD Antenna Farm and Airside
Petrol Filling Station) shall be further updated upon latest development
programme is available.
The Marine Travel Routes and
Management Plan for High Speed Ferries of SkyPier (the SkyPier Plan) was
submitted to the Advisory Council on the Environment for comment and
subsequently submitted to and approved by EPD in November 2015 under EP
Condition 2.10. The approved SkyPier Plan is available on the dedicated website
of the Project. In the SkyPier Plan, AAHK has committed to implement the
mitigation measure of requiring HSFs of SkyPier travelling between HKIA and
Zhuhai/Macau to start diverting the route with associated speed control across
the area, i.e. Speed Control Zone (SCZ), with high CWD abundance. The route
diversion and speed restriction at the SCZ have been implemented since 28
December 2015.
During the reporting period, the
SkyPier HSF travelling to and from Zhuhai and Macau has been suspended until
further notice. No SkyPier HSFs were recorded travelling between HKIA SkyPier
and Zhuhai/Macau in May 2025.
The updated
MTRMP-CAV was approved by EPD on 16 May 2025 under EP
Condition 2.9. The approved Plan is available
on the dedicated website of the Project.
ET carried out the following actions
during the reporting period:
·
One skipper training session was held by contractor’s Environmental
Officer. Competency test was subsequently conducted with trained skipper by ET.
The list of all trained skippers was properly recorded and maintained by ET.
·
During this reporting period, one skipper was trained by contractor’s
Environmental Officer. In total, 1941 skippers were trained from August 2016 to
May 2025.
·
Deviations recorded in MSS such as speeding and entering no-entry zone
were identified. All the concerned contractors were reminded to comply
with the requirements of the MTRMP-CAV during the bi-weekly Construction
Traffic Control Centre (CTCC) audit.
·
Three-month rolling programmes (one month record and three months
forecast) for construction vessel activities were received from the contractors
in order to help maintain the number of construction and associated vessels on
site to a practicable minimal level.
·
Conducted a trial for auditing construction and associated vessels
according to the updated MTRMP-CAV.
The current status of submissions
under the EP up to the reporting period is presented in Table
7.7.
Table 7.7: Status of Submissions under Environmental Permit
EP Condition |
Submission |
Status |
2.1 |
Complaint Management Plan |
Accepted / approved by EPD |
2.4 |
Management Organizations |
|
2.5 |
Construction Works Schedule and
Location Plans |
|
2.7 |
Marine Park Proposal |
|
2.8 |
Marine Ecology Conservation Plan |
|
2.9 |
Marine Travel Routes and
Management Plan for Construction and Associated Vessels |
|
2.10 |
Marine Travel Routes and
Management Plan for High Speed Ferries of SkyPier |
|
2.11 |
Marine Mammal Watching Plan |
|
2.12 |
Coral Translocation Plan |
|
2.13 |
Fisheries Management Plan |
|
2.14 |
Egretry Survey Plan |
|
2.15 |
Silt Curtain Deployment Plan |
|
2.16 |
Spill Response Plan |
|
2.17 |
Detailed Plan on Deep Cement
Mixing |
|
2.18 |
Landscape & Visual Plan |
|
2.19 |
Waste Management Plan |
|
2.20 |
Supplementary Contamination
Assessment Plan |
|
2.21 |
Procedures for Mitigation of
Aircraft Noise |
|
2.23 |
Aircraft Noise Monitoring Plan |
|
2.24 |
Airport Operation related Emissions
Control Plan |
|
2.25 |
Operational Phase Waste Management
Plan |
|
3.1 |
Updated EM&A Manual |
|
3.4 |
Baseline Monitoring Reports |
During the reporting period,
environmental related licenses and permits required for the construction
activities were checked. No non-compliance with environmental statutory
requirements was recorded. The latest statuses of the environmental licenses
and permits in the reporting period are presented in Appendix E.
A complaint was received on 25 April 2025 concerning
dust nuisance at South Wing Level 6 of Terminal 2 Concourse. In accordance with
the Project’s Manual and Complaint Management Plan, the ET initiated an
investigation. The relevant contractor confirmed that mixing works had been
conducted in the area. Prior to resuming such activities, dust mitigation
measures were enhanced and training was provided to workers. ET conducted site
inspections and did not observe any dust-related items. The contractor was reminded
to continue reviewing dust control measures and ensure proper training is
provided before future mixing works. Based on the findings, the complaint case
is considered resolved and closed.
Neither notification of summons nor prosecution was received
during the reporting period.
Cumulative statistics on complaints, notifications of summons and status of prosecutions are summarised in Appendix F.
Key activities anticipated in
the next reporting period for the Project will include the following:
Reclamation
Works:
Contract
3206 Main Reclamation Works
·
Installation of precast units, scour apron,
armour rocks and miscellaneous works at eastern seawall.
Airfield
Works:
Contract
3305 Airfield Ground Lighting System
·
Cable laying works; and
·
Hardware installation works.
Contract 3310 North Runway Modification Works
·
Demolition of bulkhead wall, pavement, drainage
works, profile barrier, mechanical, electrical and plumbing works, and
architectural, builder's work and finishing works at vehicular tunnels;
·
Falsework and formwork;
·
Reinforced concrete works;
·
Drainage and watermain works; and
·
Architectural, builder's work and finishing
works at ancillary buildings.
Terminal 2 Concourse and Apron Works:
Contract
3404 Integrated Airport Control System
·
System testing works.
Contract 3408 Third Runway Concourse and Apron Works
·
Building services and architectural, builder's
work and finishing works;
·
Cable laying and utilities works;
·
Pavement works;
·
Operation of concrete batching plant; and
·
Reinforced concrete works.
Terminal 2 Expansion:
Contract
3508 Terminal 2 Expansion Works
·
Architectural, builder's work and finishing
works;
·
Electrical and mechanical works;
·
Roof works;
·
Hard landscape works;
·
Link bridge works;
·
Emergency vehicular access construction;
·
Pier, deck, parapet and abutment construction;
·
Road works, drainage and utilities works; and
·
Crossroad duct laying works.
Automated People Mover and Baggage
Handling System:
Contract
3601 New Automated People Mover System (TRC Line)
·
Guide beam installation; and
·
Cable containment and cable laying works.
Contract
3602 Existing APM System Modification Works
·
Restoration of buffer stop;
·
Platform screen door installation works; and
·
Steel fixing and formwork to track plinth.
Contract
3603 Baggage Handling System (BHS)
·
IT cabling and commissioning;
·
Steel work, mechanical, electrical, CCTV and
IT installation; and
·
Conveyor, electrical and fire service
installation .
Airport Support Infrastructure:
Contract
3801 APM and BHS Tunnels on Existing Airport Island
·
Slope levelling works; and
·
Construction of U-channel
Contract 3802
APM and BHS Tunnels and Related Works
·
Lateral supports and backfilling works;
·
Box culvert construction and superstructure
works;
·
APM and BHS Tunnel construction;
·
Reinforced concrete works; and
· Architectural, builder's work and finishing works.
Contract
3804 East and Landside Fire Stations
·
Superstructure works;
·
Electrical and mechanical works;
·
Utilities works; and
·
Architectural, builder's work and finishing
works.
Contract
3805 New Airport District Police Operational Base
·
Construction of superstructures and drainage
system;
·
Installation of fuel tank; and
·
Site formation works.
Construction Support:
Contract
3901A Concrete Batching Facility
· Operation
of concrete batching plant and material conveyor belt.
Contract
3901B Concrete Batching Facility
·
Decommissioning of concrete batching plant.
Contract
3908 Quay Management Services
·
Provision of services of site management and
logistic control of 3RS quays; and
·
Provision of flat top barge and vehicle
delivery services between the launching point in Hong Kong and 3RS quays.
Contract
3913 Asphalt Batching Plant
· Operation of asphalt batching plant.
The key environmental issues for
the Project in the coming reporting period are expected to be associated with
the construction activities include:
·
Generation of dust from construction works and stockpiles;
·
Noise from operating equipment and machinery on-site;
·
Generation of site surface runoffs and wastewater from activities
on-site;
·
Sorting, recycling, storage and disposal of general refuse and
construction waste;
·
Reuse of treated marine sediments from excavation works; and
·
Management of chemicals and avoidance of oil spillage on-site.
The implementation of required
mitigation measures by the contractors will be monitored by the ET.
A tentative schedule of the
planned environmental monitoring work and the operation phase CWD monitoring in
the next reporting period is provided in Appendix B.
With reference to Appendix E of
the Manual, it is noted that the key assumptions adopted in approved EIA report
for the construction phase are still valid and no major changes are involved.
The environmental mitigation measures recommended in the approved EIA Report
remain applicable and shall be implemented in undertaking construction works
for the Project.
The new
North Runway was commissioned in November 2022. Following the completion of
reconfiguration works on the Centre Runway, the 3RS was commissioned on 28
November 2024.
The key activities of the Project carried out in the
reporting period are located in reclamation areas and existing airport island
respectively. Works in the reclamation areas included concourse superstructure
works, tunnel works for Automated People Mover (APM) and Baggage Handling
System (BHS) and associated works. Meanwhile, works on the existing airport
island involved Terminal 2 (T2) expansion works, modification and tunnel works
for APM and BHS, utilities works, road and drainage works and excavation works.
All the monitoring works for construction dust, construction noise,
construction waste and landscape & visual were conducted during the
reporting period in accordance with the Manual.
Monitoring results of construction dust, construction noise and
construction waste did not trigger the corresponding Action and Limit Levels
during the reporting period. No non-conformity was recorded for landscape &
visual monitoring in the reporting period.
The operation phase CWD
monitoring was conducted in May 2025.
Weekly site inspections of the
construction works were carried out by the ET to audit the implementation of proper
environmental pollution control and mitigation measures for the Project.
Bi-weekly site inspections were also conducted by the IEC. Site inspection
findings were recorded in the site inspection checklists and provided to the
contractors to follow up.
On the implementation of the
SkyPier Plan, SkyPier HSF services to and from Zhuhai and Macau has been
suspended until further notice. No SkyPier HSFs were recorded travelling
between HKIA SkyPier and Zhuhai/Macau during the reporting period.
For the implementation of
MTRMP-CAV, the MSS automatically recorded the deviation cases such as speeding
and entering no-entry zone. The ET checked the MSS records to ensure all
deviation cases were followed up. All the concerned captains were reminded by
the contractor’s CTCC representative to comply with the requirements of the
MTRMP-CAV. Three-month rolling programmes for construction vessel activities,
which ensures the proposed vessels are necessary and minimal through good
planning, were also received from contractors.
[1] The Manual is available on the Project’s dedicated
website (accessible at: http://env.threerunwaysystem.com/en/index.html).
